| Project Entry Gate, RCC Section, Security Guard Cabin, Aluminium/MS Section |
Completed 100% |
Nil |
Work Finished 100% |
| Underground Water Tank |
Completed 100% |
Nil |
Work Finished 100% |
| Project Boundary Wall |
Completed 100% |
Nil |
Work Finished 100% |

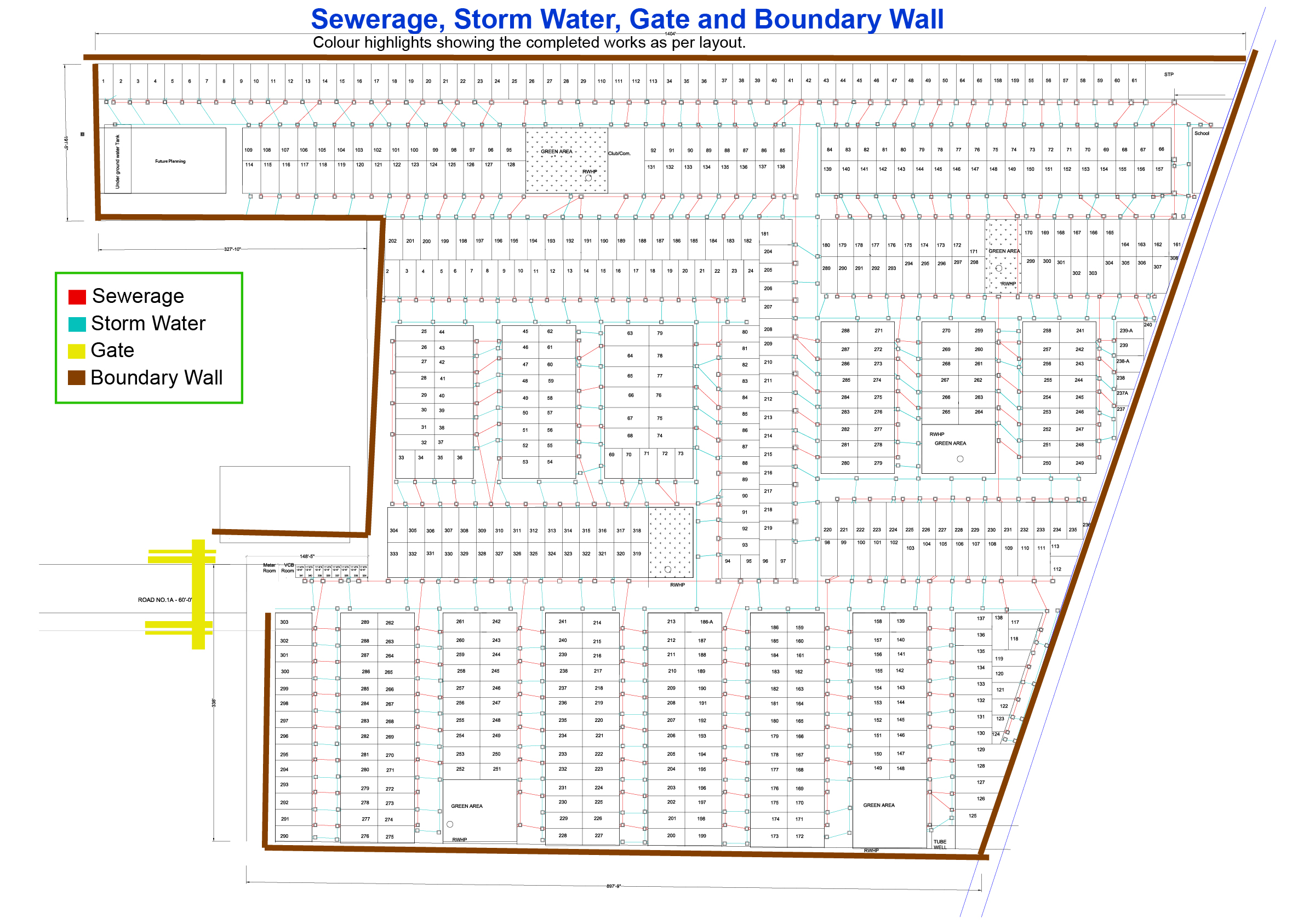

| Sewerage System |
Completed 90% |
Remaining 10% STP |
31 December 2023 |
| Strom Water Drainage System |
Completed 80% |
Remaining 20% |
30 November 2023 |

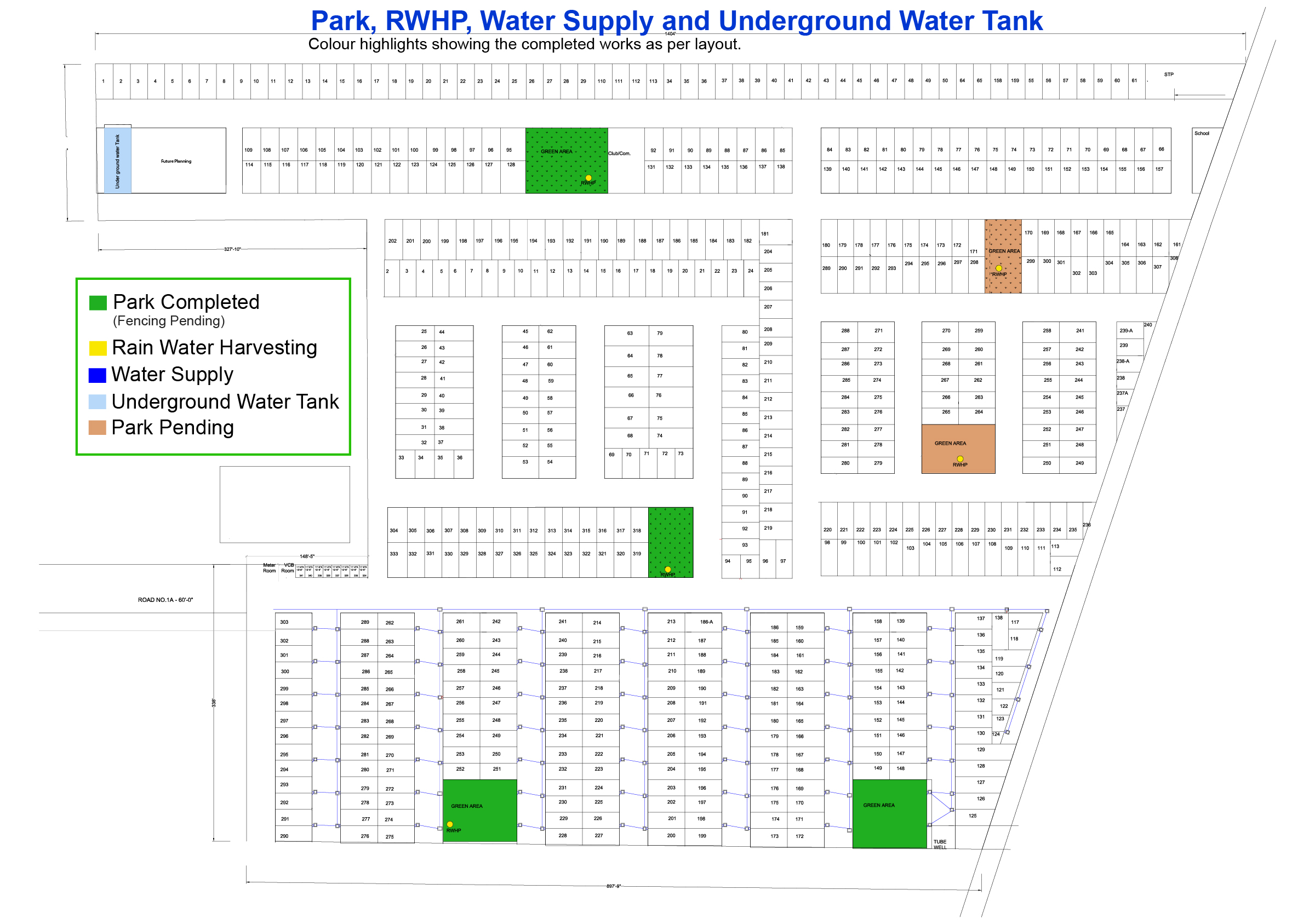

| Rain Water Harvesting |
Completed 70% |
Remaining 30% |
30 November 2023 |
| Project Internal Roads |
Completed 40% |
Remaining 60% Final GSB & Blacktop |
31 December 2023 |
| Water Connection to each Plot |
Completed 30% |
Remaining 70% |
30 September 2023 |

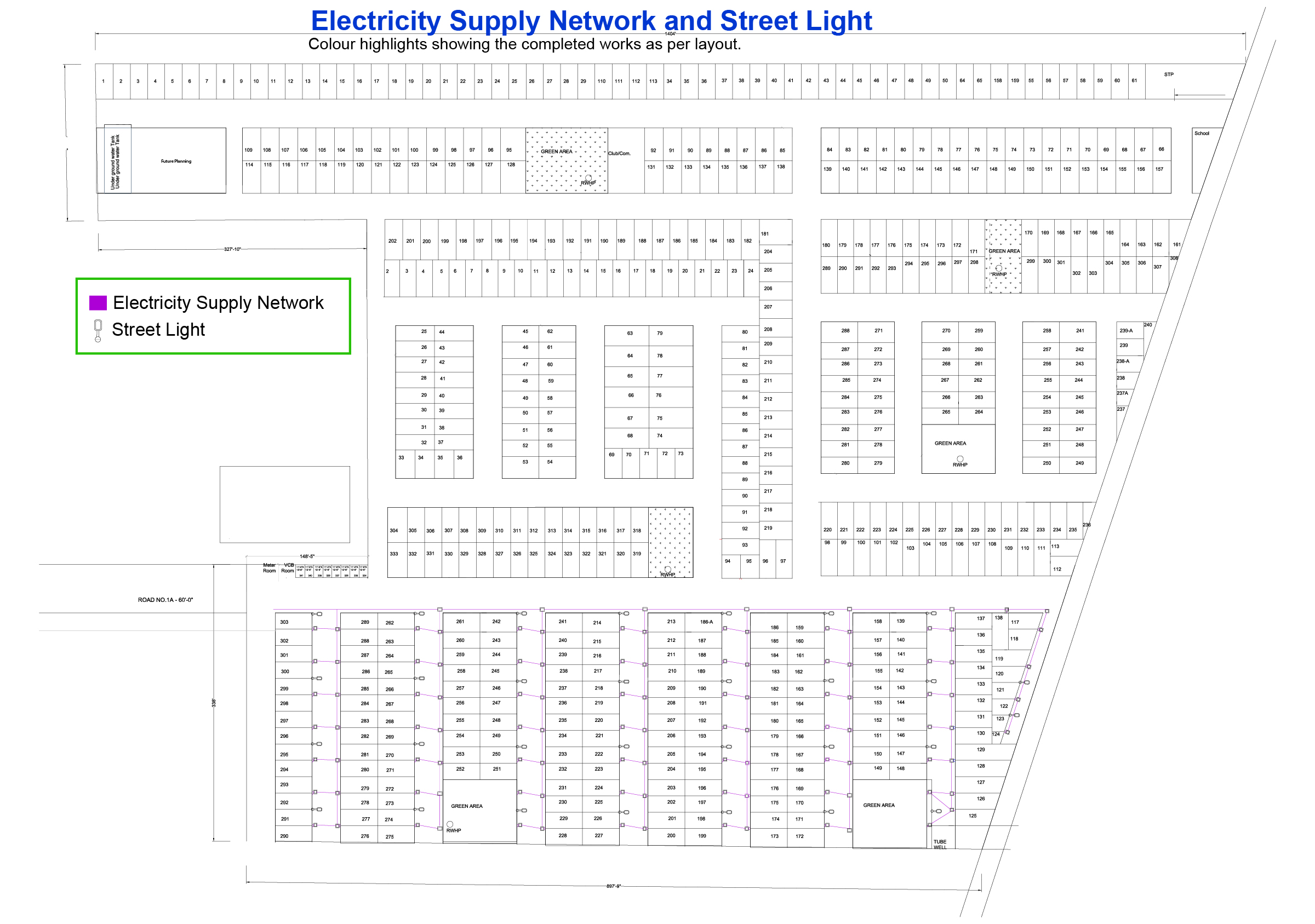

| Electrical Conduiting and Cabling to each Plot |
Completed 20% |
Remaining 80% |
31 January 2024 |
| External Lighting Poles |
Completed 20% |
Remaining 80% |
30 September 2023 |
| Gardens with Play Area |
Completed 60% |
Remaining 40% |
30 September 2023 |
| Landscaping |
Completed 60% |
Remaining 40% |
30 October 2023 |
| Construction of Community Center shall start after finishing the above
mentioned basic infrastructure work |
To start in Feb 2024 |
